Cokato Construction Updates

Nuvera Fiber Internet Expansion

Have a construction question or restoration request?

Fiber construction projects happen in five main steps.  They are typically in the following order but sometimes order may vary slightly.

  1. Installation and customer connection.  Once a neighborhood is fiber-ready, current customers and new customers that signed up for service will be contacted about the installation their new fiber internet service.
  2. Mainline construction.  This is placing the main fiber line in either the public right-of ways or alleys.
  3. Cable pulling.  Fiber is pulled through the main line that was placed.
  4. Mainline splicing and testing.  Fiber optic splicing is the process of joining two separate fiber optic cables together. It is then tested for its strength.
  5. Drops to homes.  Facilities or “drops” are buried from the mainline to the customer’s home.  This includes placing the fiber which will also be spliced and tested.

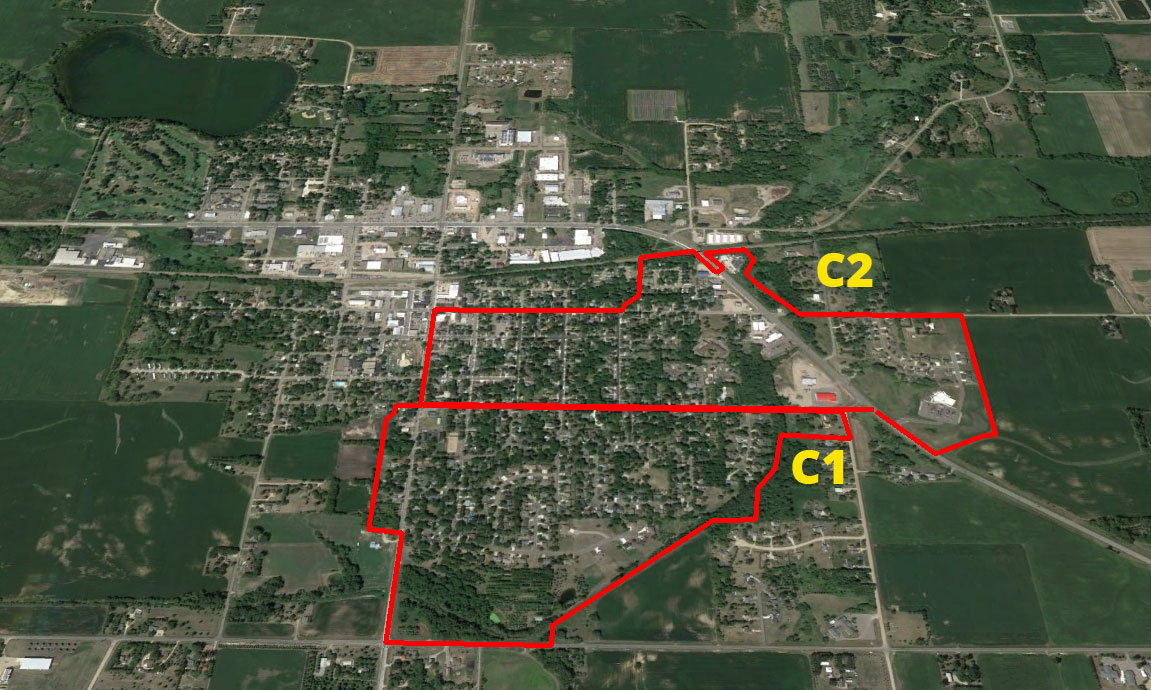

Cokato, MN 55321 Updates

02/04/2025

C2
Great news!  This area is ready for fiber!  In the upcoming weeks, new customers that signed up for fiber will be contacted for installation and current customers will be contacted to migrate to fiber.

01/07/2025

C1
Great news!  This area is ready for fiber!  In the upcoming weeks, new customers that signed up for fiber will be contacted for installation and current customers will be contacted to migrate to fiber.

C2
The estimated date for this area to be fiber-ready is January, after which fiber installations will be on-going. Completion dates may vary.  Watch here for more details.

12/31/2024

C1
Great news!  This area is ready for fiber!  In the upcoming weeks, new customers that signed up for fiber will be contacted for installation and current customers will be contacted to migrate to fiber.

C2
The estimated date for this area to be fiber-ready is January, after which fiber installations will be on-going. Completion dates may vary.  Watch here for more details.

12/17/2024

C1
Great news!  This area is ready for fiber!  In the upcoming weeks, new customers that signed up for fiber will be contacted for installation and current customers will be contacted to migrate to fiber.

C2
The estimated date for this area to be fiber-ready is December, after which fiber installations will be on-going. Completion dates may vary.  Watch here for more details.

12/10/2024

C1
Great news!  This area is ready for fiber!  In the upcoming weeks, new customers that signed up for fiber will be contacted for installation and current customers will be contacted to migrate to fiber.

C2
The estimated date for this area to be fiber-ready is December, after which fiber installations will be on-going. Completion dates may vary.  Watch here for more details.

12/03/2024

C1
Great news!  This area is ready for fiber!  In the upcoming weeks, new customers that signed up for fiber will be contacted for installation and current customers will be contacted to migrate to fiber.

C2
The estimated date for this area to be fiber-ready is December, after which fiber installations will be on-going. Completion dates may vary.  Watch here for more details.

11/26/2024

C1
Great news!  This area is ready for fiber!  In the upcoming weeks, new customers that signed up for fiber will be contacted for installation and current customers will be contacted to migrate to fiber.

C2
The estimated date for this area to be fiber-ready is December, after which fiber installations will be on-going. Completion dates may vary.  Watch here for more details.

11/19/2024

C1
Great news!  This area is ready for fiber!  In the upcoming weeks, new customers that signed up for fiber will be contacted for installation and current customers will be contacted to migrate to fiber.

C2
The estimated date for this area to be fiber-ready is December, after which fiber installations will be on-going. Completion dates may vary.  Watch here for more details.

11/12/2024

C1
The estimated date for this area to be fiber-ready is November, after which fiber installations will be on-going. Completion dates may vary.  Watch here for more details.

C2
Splicing and drops to customer homes are in progress.

The estimated completion date for this area is November but may vary due to circumstances out of Nuvera’s control.

11/05/2024

C1
The estimated date for this area to be fiber-ready is November, after which fiber installations will be on-going. Completion dates may vary.  Watch here for more details.

C2
Cable pulling, splicing and drops to customer homes are in progress.

The estimated completion date for this area is November but may vary due to circumstances out of Nuvera’s control.

10/29/2024

C1
The estimated date for this area to be fiber-ready is November, after which fiber installations will be on-going. Completion dates may vary.  Watch here for more details.

C2
Mainline construction is complete. Cable pulling and drops to customer homes are in progress.

The estimated completion date for this area is November but may vary due to circumstances out of Nuvera’s control.

10/22/2024

C1
The estimated date for this area to be fiber-ready is October, after which fiber installations will be on-going. Completion dates may vary.  Watch here for more details.

C2
Mainline construction and drops to customer homes are in progress.

The estimated completion date for this area is October but may vary due to circumstances out of Nuvera’s control.

10/15/2024

C1
The estimated date for this area to be fiber-ready is October, after which fiber installations will be on-going. Completion dates may vary.  Watch here for more details.

C2
Mainline construction and drops to customer homes are in progress.

The estimated completion date for this area is October but may vary due to circumstances out of Nuvera’s control.

10/08/2024

C1
Cable pulling, mainline splicing and drops are complete.

The estimated date for this area to be fiber-ready is October, after which fiber installations will be on-going. Completion dates may vary.  Watch here for more details.

C2
Mainline construction is in progress.

The estimated completion date for this area is October but may vary due to circumstances out of Nuvera’s control.

10/01/2024

C1
Splicing/testing fiber, drops to customer homes and cable pulling through the mainline are in progress.

The estimated date for this area to be fiber-ready is October, after which fiber installations will be on-going. Completion dates may vary.  Watch here for more details.

C2
Mainline construction is in progress.

The estimated completion date for this area is October but may vary due to circumstances out of Nuvera’s control.

09/24/2023

C1
Drops to customer homes and cable pulling through the mainline are in progress.

The estimated date for this area to be fiber-ready is October, after which fiber installations will be on-going. Completion dates may vary.  Watch here for more details.

C2
Mainline construction is in progress.

The estimated completion date for this area is October but may vary due to circumstances out of Nuvera’s control.

09/17/2024

C1
Drops to customer homes are in progress. Cable pulling through the mainline is in progress.

The estimated date for this area to be fiber-ready is October, after which fiber installations will be on-going. Completion dates may vary.  Watch here for more details.

C2
Mainline construction is in progress.

The estimated completion date for this area is October but may vary due to circumstances out of Nuvera’s control.

09/10/2024

C1
Drops to customer homes are in progress. Cable pulling through the mainline is in progress.

The estimated date for this area to be fiber-ready is September, after which fiber installations will be on-going. Completion dates may vary.  Watch here for more details.

C2
Mainline construction is in progress.

The estimated completion date for this area is October but may vary due to circumstances out of Nuvera’s control.

09/03/2024

C1
Mainline construction is complete and drops to customer homes are in progress.

The estimated date for this area to be fiber-ready is September, after which fiber installations will be on-going.  Completion dates may vary.  Watch here for more details.

C2
Mainline construction is in progress.

The estimated completion date for this area is September but may vary due to circumstances out of Nuvera’s control.

08/27/2024

C1
Drops to customer homes will begin soon.  Current and new customers are contacted by mailers or door tags directly at your home before we start digging.   The Nuvera team places the fiber optic cable from the pedestal up to the Network Interface Device, or NID, attached to the outside of your home. The crew then installs what’s known as a Fiber Optic Network Terminal, or O N T, inside your home. This is the heart of your new fiber internet connection, linking directly to the fiber in the NID outside.

The estimated date for this area to be fiber-ready is September, after which fiber installations will be on-going.  Completion dates may vary.  Watch here for more details.

08/20/2024

C1
Mainline construction is in progress.

The estimated completion date for this area is September but may vary due to circumstances out of Nuvera’s control.

08/13/2024

C1
Mainline construction is in progress.

The estimated completion date for this area is September but may vary due to circumstances out of Nuvera’s control.

08/06/2024

C1
Mainline construction will start this week and includes several important steps.  The first steps you will see in your neighborhood are:

Marking of utilities with paint and flags in the construction area. Please do not remove flags or paint markings. Flags will be removed after construction is complete and the paint markings will fade on their own.

Once locate flags are placed in your yard you must locate and mark any private underground facilities such as: invisible fencing, irrigation lines, private power, etc.

Main line boring to place conduit for fiber-optic line to be pulled through.

Construction may cause minor disruption to your yard or landscaping. Crews will restore any impacted areas following construction.

The estimated completion date for this area is September but may vary due to circumstances out of Nuvera’s control.

07/30/2024

C1
Mainline construction is scheduled to start the week of August 5 and includes several important steps.  The first steps you will see in your neighborhood are:

Marking of utilities with paint and flags in the construction area. Please do not remove flags or paint markings. Flags will be removed after construction is complete and the paint markings will fade on their own.

Once locate flags are placed in your yard you must locate and mark any private underground facilities such as: invisible fencing, irrigation lines, private power, etc.

Main line boring to place conduit for fiber-optic line to be pulled through.

Construction may cause minor disruption to your yard or landscaping. Crews will restore any impacted areas following construction.

The estimated completion date for this area is September but may vary due to circumstances out of Nuvera’s control.

07/23/2024

C1
Mainline construction is scheduled to start the week of July 29 and includes several important steps.  The first steps you will see in your neighborhood are:

Marking of utilities with paint and flags in the construction area. Please do not remove flags or paint markings. Flags will be removed after construction is complete and the paint markings will fade on their own.

Once locate flags are placed in your yard you must locate and mark any private underground facilities such as: invisible fencing, irrigation lines, private power, etc.

Main line boring to place conduit for fiber-optic line to be pulled through.

Construction may cause minor disruption to your yard or landscaping. Crews will restore any impacted areas following construction.

The estimated completion date for this area is September but may vary due to circumstances out of Nuvera’s control.

7/16/2024

C1
Mainline construction is scheduled to start the week of July 22 and includes several important steps.  The first steps you will see in your neighborhood are:

Marking of utilities with paint and flags in the construction area. Please do not remove flags or paint markings. Flags will be removed after construction is complete and the paint markings will fade on their own.

Once locate flags are placed in your yard you must locate and mark any private underground facilities such as: invisible fencing, irrigation lines, private power, etc.

Main line boring to place conduit for fiber-optic line to be pulled through.

Construction may cause minor disruption to your yard or landscaping. Crews will restore any impacted areas following construction.

The estimated completion date for this area is September, but may vary due to circumstances out of Nuvera’s control.

5/31/2024

  • Construction in Cokato will begin in late June or early July.
  • The project will be completed over a 2-year period, with some neighborhoods beginning construction in 2024 with the remainder in 2025.
  • Before construction begins, flags and paint markings will be placed in the rights-of-way and/or alleyways where mainline construction will occur.
  • Property owners in the current build area have or will receive construction communications prior to activity in their area and are encouraged to sign up for service as soon as possible.
  • Residents are also able to check on status of the overall construction project in their community by visiting this page.
  • Residents are encouraged to sign up early by calling Nuvera’s local team at 844.354.4111 or visiting NuveraGigCities.com
  • For business services, visit Nuvera.net/Business or talk to Nuvera’s local business team at 844.610.5300.
