Prior Lake Sand Point Construction Updates

Nuvera Fiber Internet Expansion

Have a construction question or restoration request?

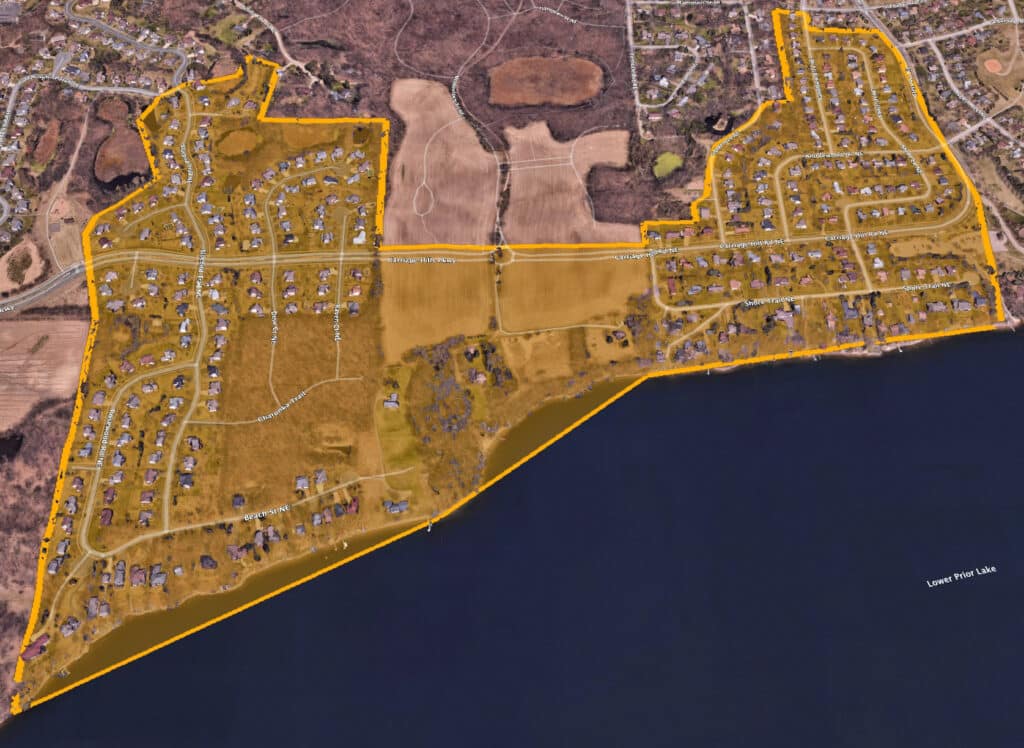

Prior Lake Sand Point 2025

Fiber construction projects typically happen in the following order but may vary slightly.

  1. Site Preparation.  Before construction begins, crews will mark utility lines in the area using paint and flags. Please do not remove flags or paint markings. Homeowners are responsible for marking any private underground systems, such as sprinkler lines or invisible fences.
  2. Mainline Construction.  The main fiber line is placed in either the public right-of way or alley and then fiber pulled through.
  3. Drop Construction.  Fiber is extended from the main line to individual homes. This step involves burying a line, or “drop”, and pulling fiber through to each address.
  4. Splicing.  Fiber cables are joined together through a process called splicing and then tested to confirm the connection is strong and reliable. This step is done on both the mainline and the line going to each home.
  5. Installation.  Once a neighborhood is fiber-ready, current customers and new customers that signed up for service will be contacted about the installation of their new fiber internet service.


Construction may cause minor disruption to your yard or landscaping. Crews will restore any impacted areas following construction.

Prior Lake, MN 55373 Updates (Sand Point)

09/16/2025

SP3
Restoration and cleanup are continuing. Final inspection is underway.

09/09/2025

SP3
Restoration is continuing.

09/02/2025

SP3
Restoration is continuing.

08/25/2025

SP3
Restoration is continuing.

8/19/2025

SP3
Restoration is taking place.

08/12/2025

SP3
Restoration is taking place. Splicing is complete.

08/05/2025

SP3
Restoration is taking place.

07/29/2025

SP3
Restoration is taking place.

07/22/2025

SP3
Drops are complete. Restoration is taking place.

07/15/2025

SP3
Drops are complete. Hydroseeding taking place.

07/08/2025

SP3
Duct installs are completed. Pulling fiber up Rosewood to Bluebird. Drops to be done this week. Hydroseeding taking place later this week.

07/01/2025

SP3
Mainline construction crews are working on Beach Street and Rosewood. Duct work should be completed this week. Cleanup and restoration taking place on East side.  Cable pulling remains to be done on 5 streets.  Splicing to follow after this is completed.

06/24/2025

SP3
Mainline construction crews are working on the east end of Beach Street and on Bluebird (the north side of Carriage Hills).

Crews will continue pulling fiber this week.

The drop crew is right behind the mainline crew.

The splicing crew is right behind the drop crew.

06/17/2025

SP3
Mainline construction crews are working on the east end of Beach Street and on Bluebird (the north side of Carriage Hills). They have finished Raven Court.

Crews will continue pulling fiber this week.

The drop crew is right behind the mainline crew.

Splicing has started.

06/10/2025

SP3
Mainline construction crews are on Dove Ct N from Carriage Hills, moving over to Bluebird. Raven Court NE will be finished up and moving over to Nightengale Cir NE.

Crews will continue pulling fiber this week. All fiber is pulled from Ferndale Ave NE – hydroseeding/lawn restoration is starting today.

The drop crew is right behind the mainline crew on Bluebird Trail NE (south of Carriage Hills).

Splicing has started east of Ferndale Ave NE.

06/03/2025

SP3
Mainline construction is continuing along Amblewood and Bluebird.

Drops are in progress.

Cable pulling will start soon.

05/27/2025

SP3
Mainline construction along lake-adjacent footage is continuing.

05/20/2025

SP3
Mainline construction along lake-adjacent footage is continuing.

05/13/2025

SP3
Mainline along Carriage Hill (Pike Lake Trail east to Ferndale) will be done this week. Carriage Hill to Amblewood Drive will start next week. Crews are attempting to complete lake-adjacent footage first as summer lake activities are beginning.

05/06/2025

SP3
Mainline construction is continuing. Cable pulling is also beginning.

04/29/2025

SP3

Construction has begun on Shore Lane, Shore Trail and Carriage Hill Road.

04/23/2025

SP3
Mainline construction is scheduled to start the week of April 28 and includes several important steps.  The first steps you will see in your neighborhood are:

Marking of utilities with paint and flags in the construction area. Please do not remove flags or paint markings. Flags will be removed after construction is complete and the paint markings will fade on their own.

Once locate flags are placed in your yard you must locate and mark any private underground facilities such as: invisible fencing, irrigation lines, private power, etc.

Main line boring will take place in either the public right-of way or alley and then fiber pulled through.

Construction may cause minor disruption to your yard or landscaping. Crews will restore any impacted areas following construction.

Not a Nuvera Customer?

Sign up for presale service to get fiber facilities buried to your home during construction.
